City One Development, an investment and development company, continues actively constructing new phases of the business-class “Novopecherski Lypky Quarter.”
As the month draws to a close, it’s time to provide more detailed information about the completed works and progress of construction in March for phases 7 and 8:

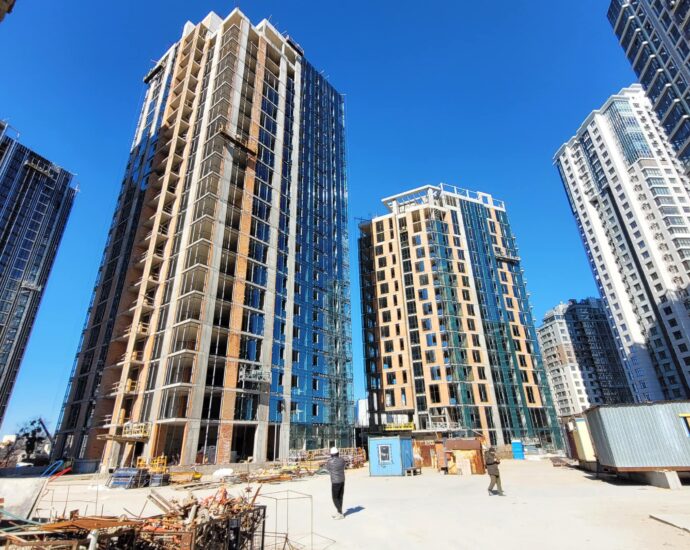

Phase 7 (Project numbers of buildings 1, 2, 3, 4)
Building 1:
- Electrical distribution and installation of cable-conductor products in apartments and common areas are ongoing.
- Radiator installation in apartments is in progress.
- Decorative works in common areas and entrance groups are ongoing.

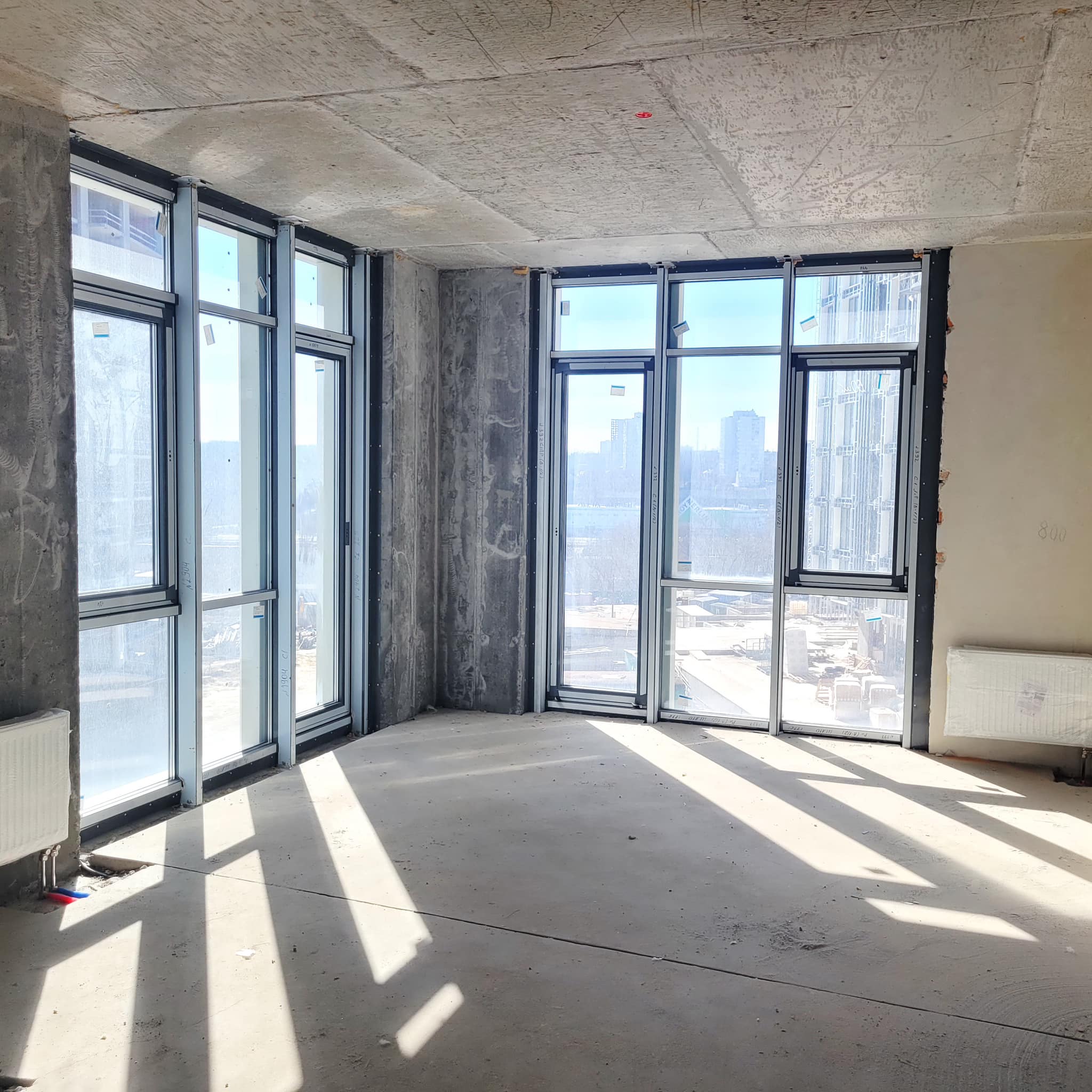

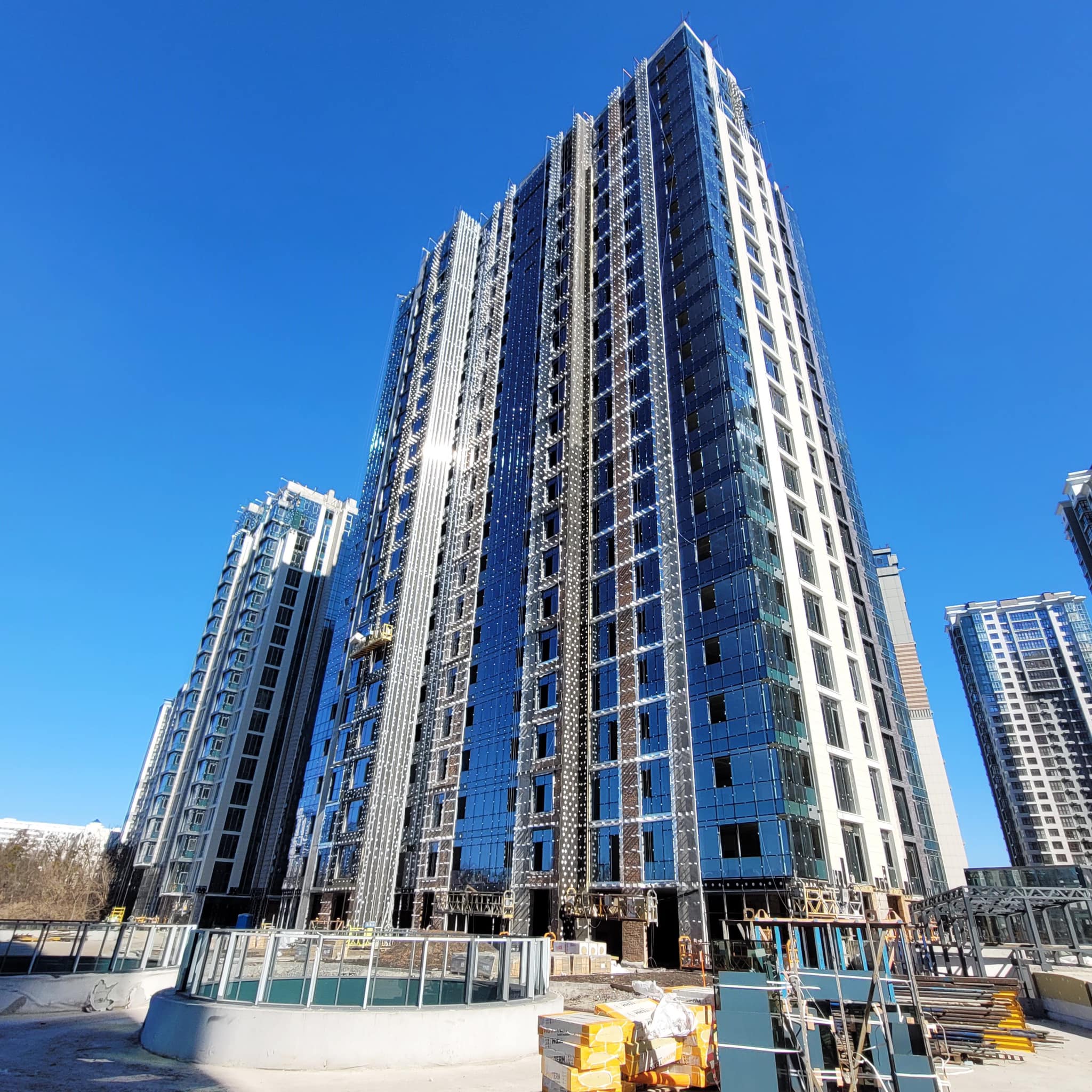

- Installation of aluminum window glazing and facade structure is in the final stages.
- Completion of ventilation and heating systems in the underground parking.
- Installation of internal gates in the parking area is ongoing.
- Finalization of architectural lighting works is ongoing.
- Landscaping of the adjacent territory is in progress.
Building 2:
- Installation of doors in common areas has been completed.
- Installation of entrance apartment doors from the 6th floor and above is ongoing.
- Completion of structures connecting buildings 2-3 to the central street of the quarter.
- Installation of entrance gates to parking areas is ongoing.

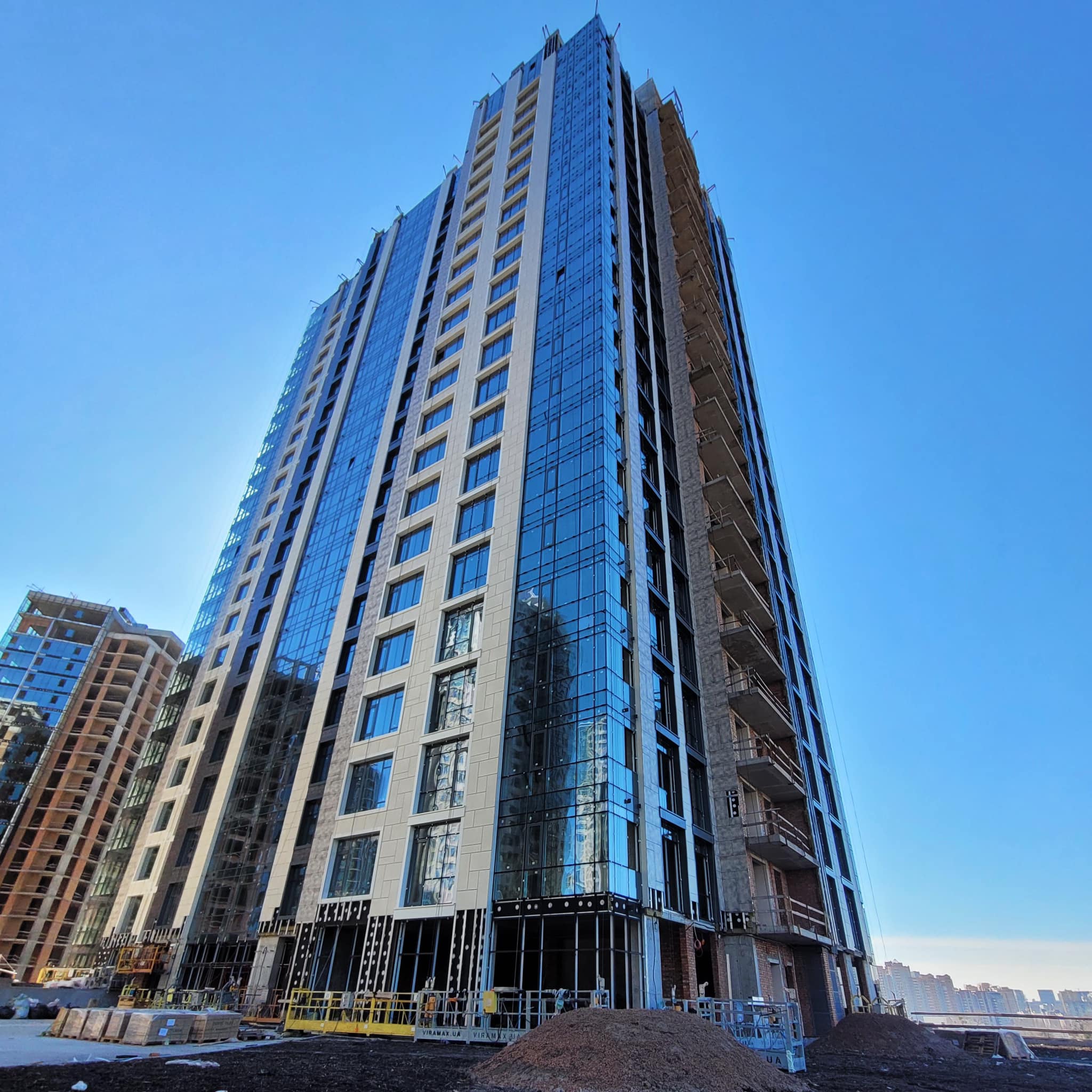

- Insulation with non-combustible mineral wool and installation of ventilated facade is nearing completion.

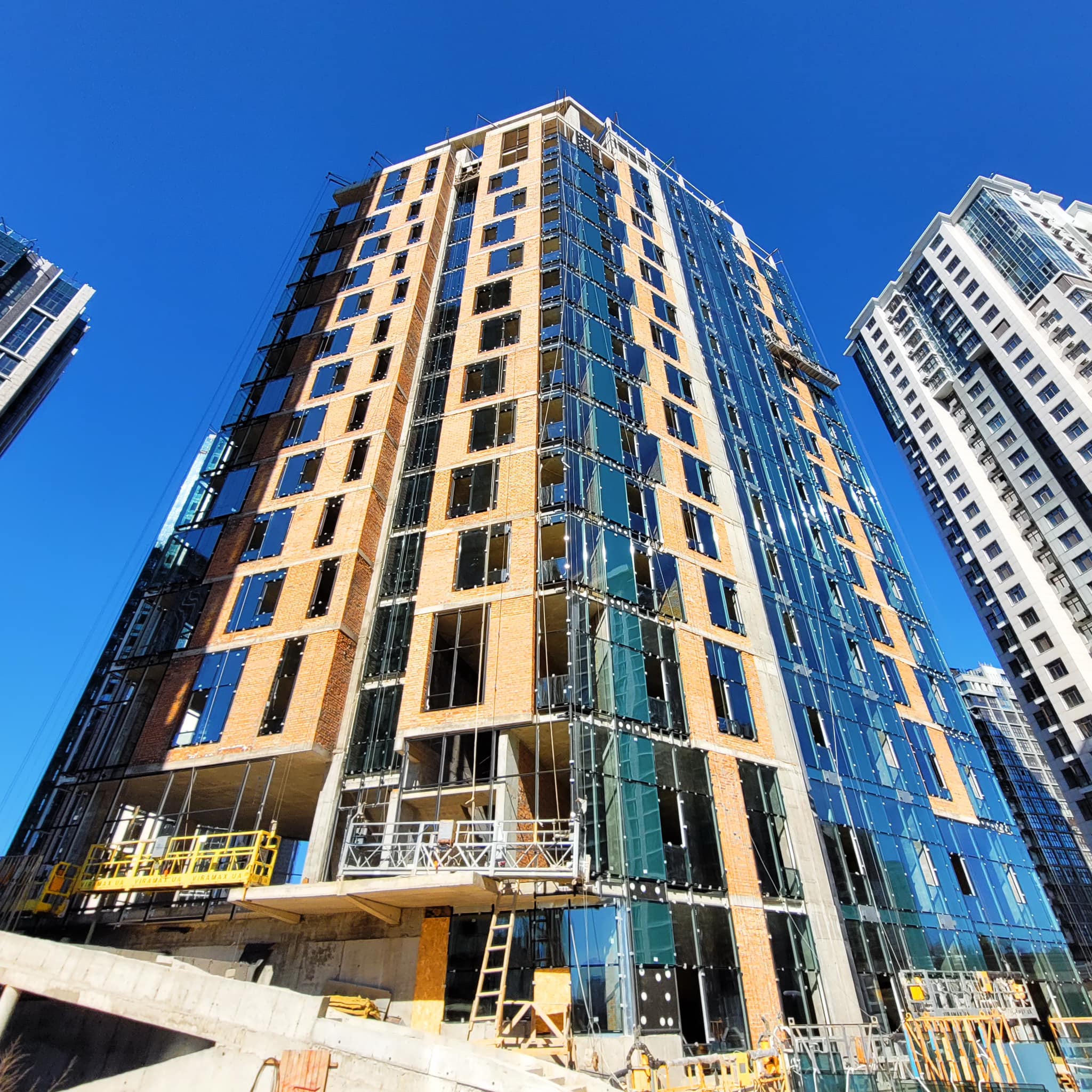

- Finalization of architectural lighting and window glazing and facade structures is underway.
- Landscaping of the adjacent territory continues.
Building 3:
- Installation of entrance apartment doors from the 7th floor and above is ongoing.
- Radiator installation in apartments is ongoing.
- Completion of ventilated facade and installation of window elements on the parapet part of the building.
- Finalization of decorative works in common areas and installation of water supply system KAN are ongoing.
- Continued installation of facade lighting.
- Landscaping of the adjacent territory is ongoing.
Building 4:
- Electrical distribution and installation of cable-conductor products in apartments and common areas are ongoing.
- Decorative works in common areas and entrance groups are ongoing.
- Installation of apartment doors has been completed.
- Installation of doors in common areas is ongoing.
- Radiator installation in apartments is ongoing.
- Installation of facade lighting is ongoing.
- Landscaping of the adjacent territory continues.
Work on internal courtyard engineering networks (stormwater systems, sewerage, water supply, heating, etc.) is ongoing for all buildings in Phase 7.
Phase 8 (Project numbers of buildings 5, 6, 9)
Club-format Building 9:

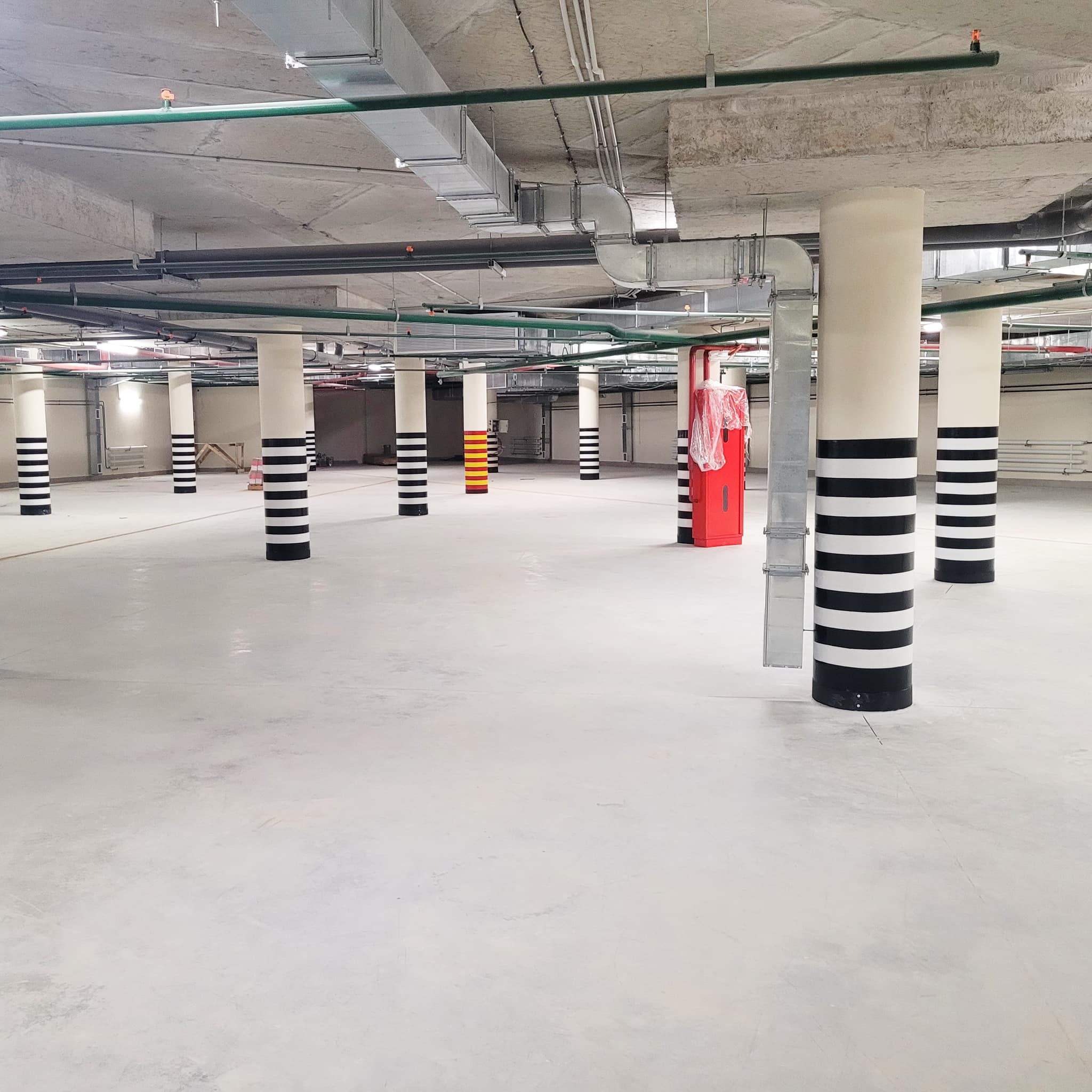

- Completion of floor installations in the underground parking.
- Continued installation of fire protection systems, alarm systems, dispatching, and automation systems.

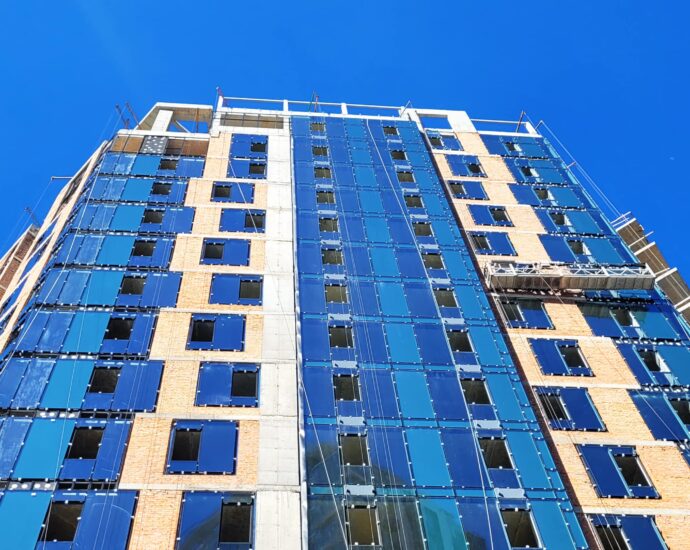

- Installation of aluminum window glazing structures and transparent facade structures from floors 1 to 16 is ongoing.
Building 5:
- Final stages of installation of fire protection systems, alarm systems, dispatching, and automation systems.
- Continued installation of aluminum window glazing structures and transparent facade structures from floors 2 to 21.
- Installation of underground building communications.

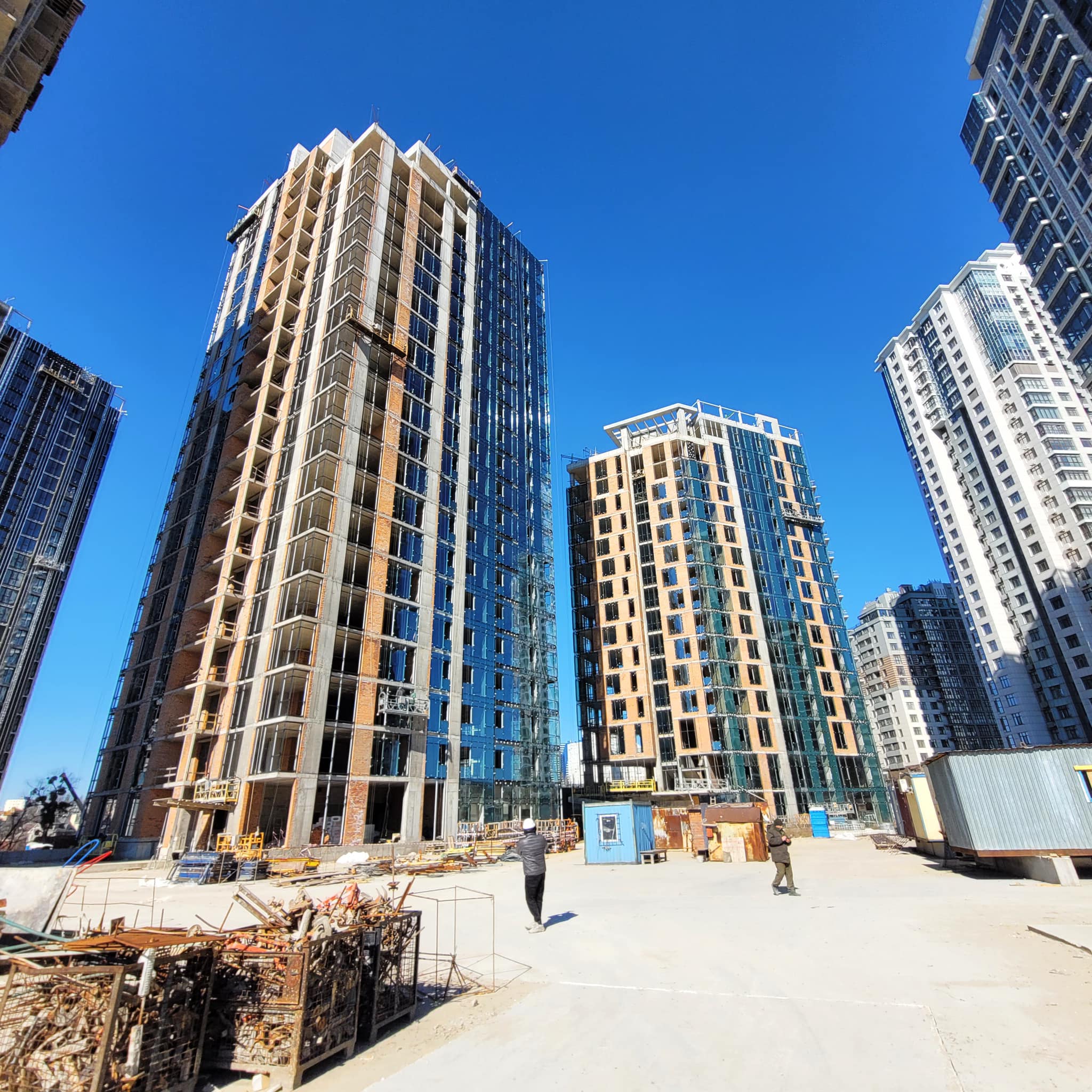

Building 6:

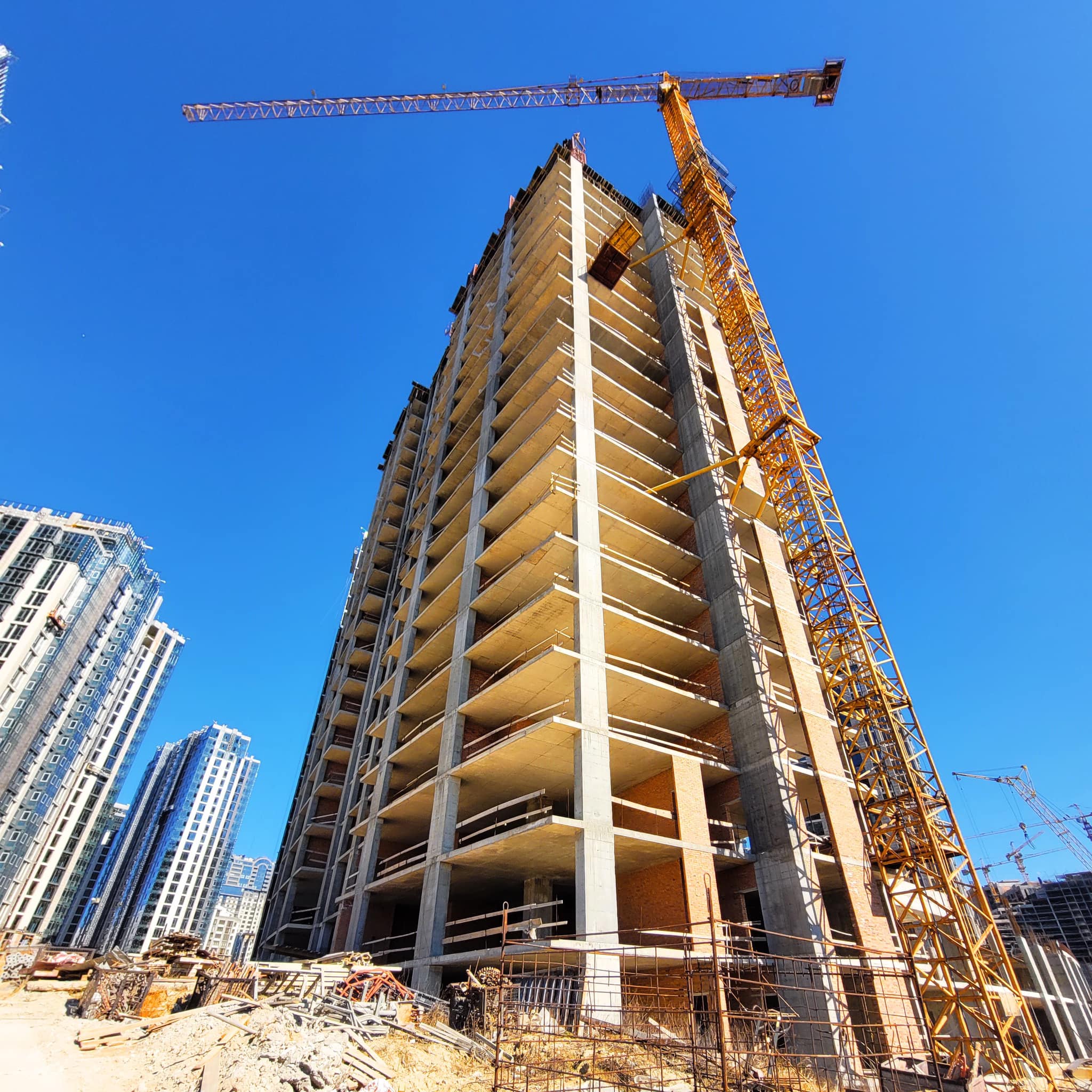

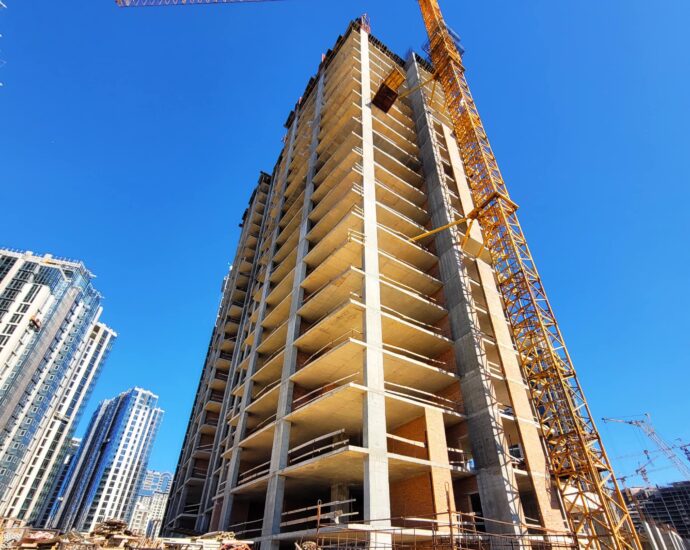

- Formwork and concrete pouring of the floor slab, vertical structures, and elements of the 21st floor of the monolithic frame are ongoing.
- Continued laying of external and internal walls at levels 14-15-16.
- Construction works on the underground parking under buildings 5-6 are ongoing.
Construction of the monolithic frame for the educational center for children and installation of internal courtyard engineering networks are ongoing.
These updates highlight the progress and detailed activities across the phases of “Novopecherski Lypky Quarter.”
