The investment and development company City One Development continues to construct the business-class residential quarter “Novopecherski Lypky”.
We have prepared a new spring report for you from the construction sites of phases 7 and 8:
Phase 7

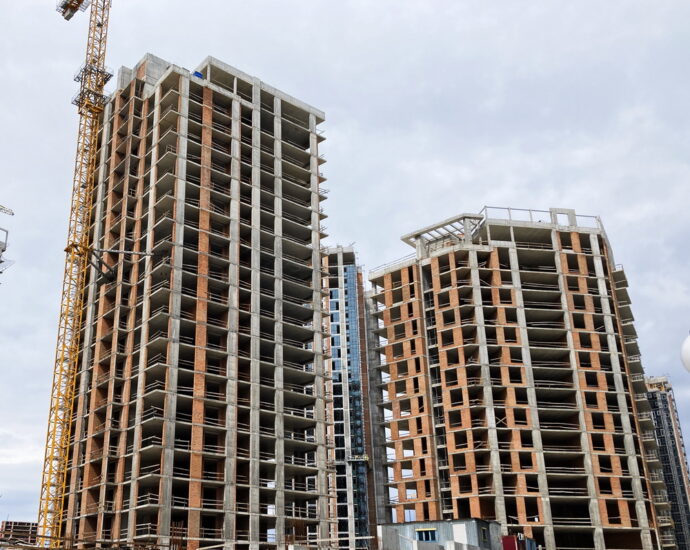

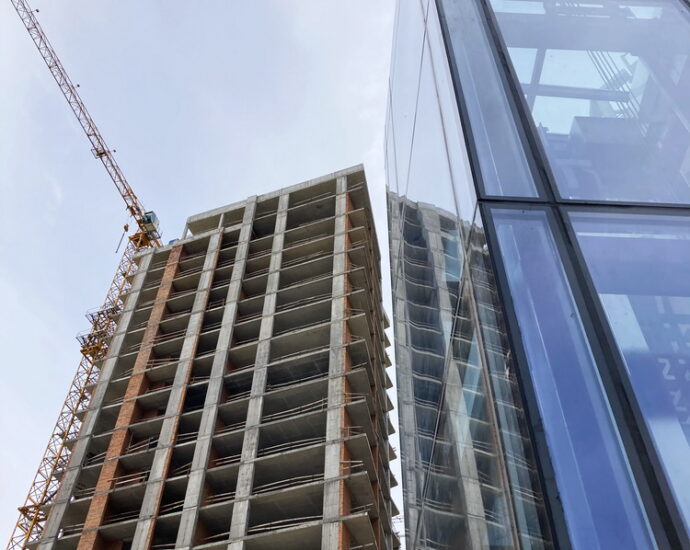

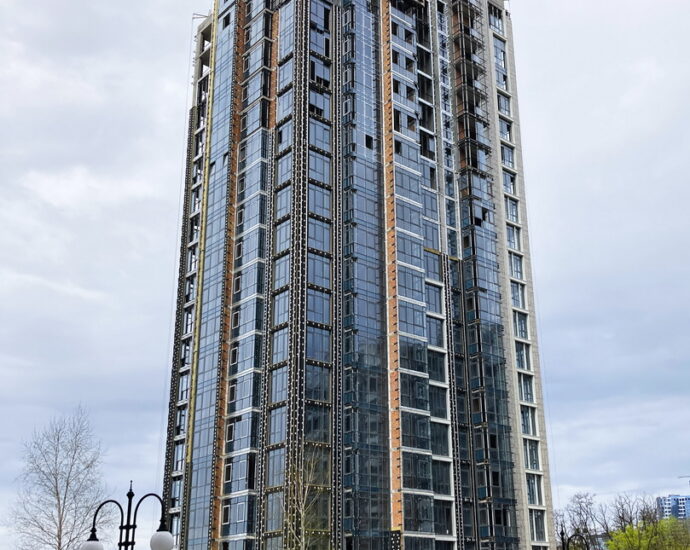

Building No.1

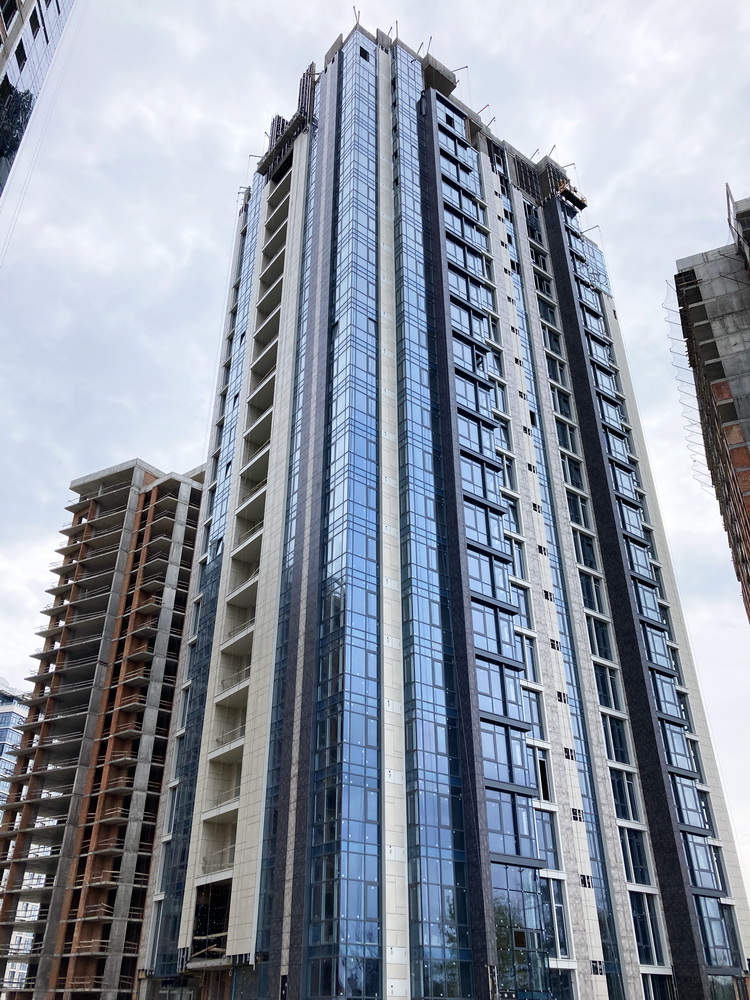

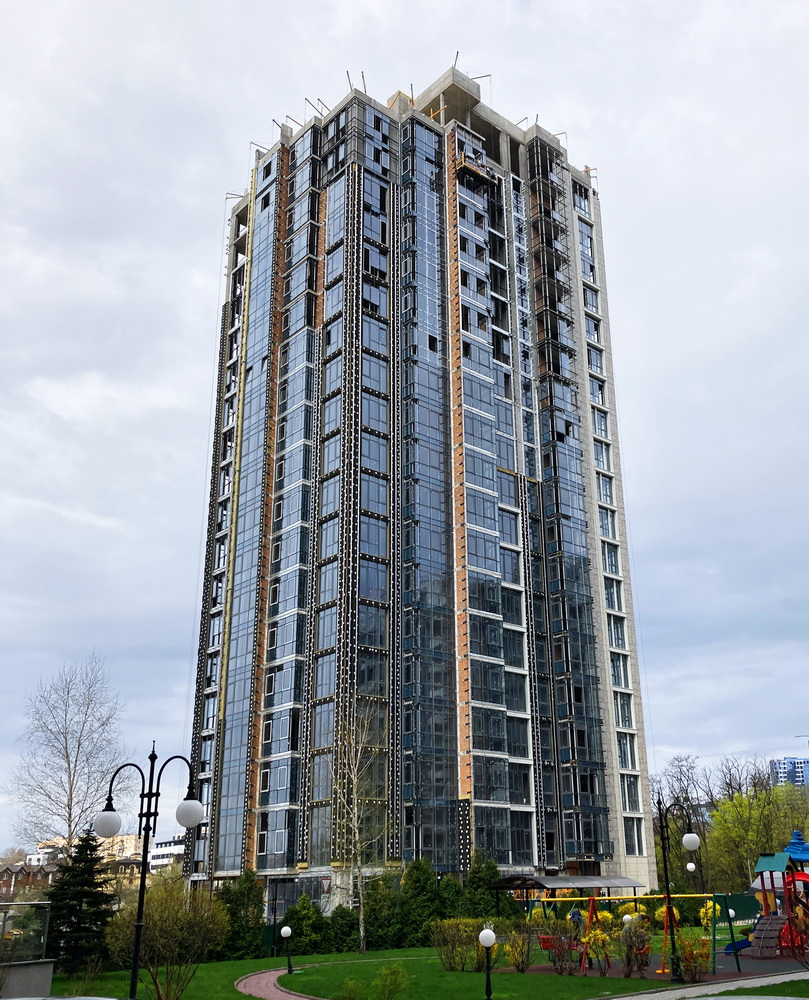

- Completing insulation of the building with non-combustible mineral wool, securing protective geomembrane, and installing profiles for the ventilated facade made of ceramic granite.
- Continuing the installation of aluminum window glazing, glassing, and installation of window and door structures on the facade.
- Continuing the arrangement of engineering networks for water supply and drainage, as well as low-voltage alarm and automation systems.
- Ongoing work on the installation of architectural facade lighting.

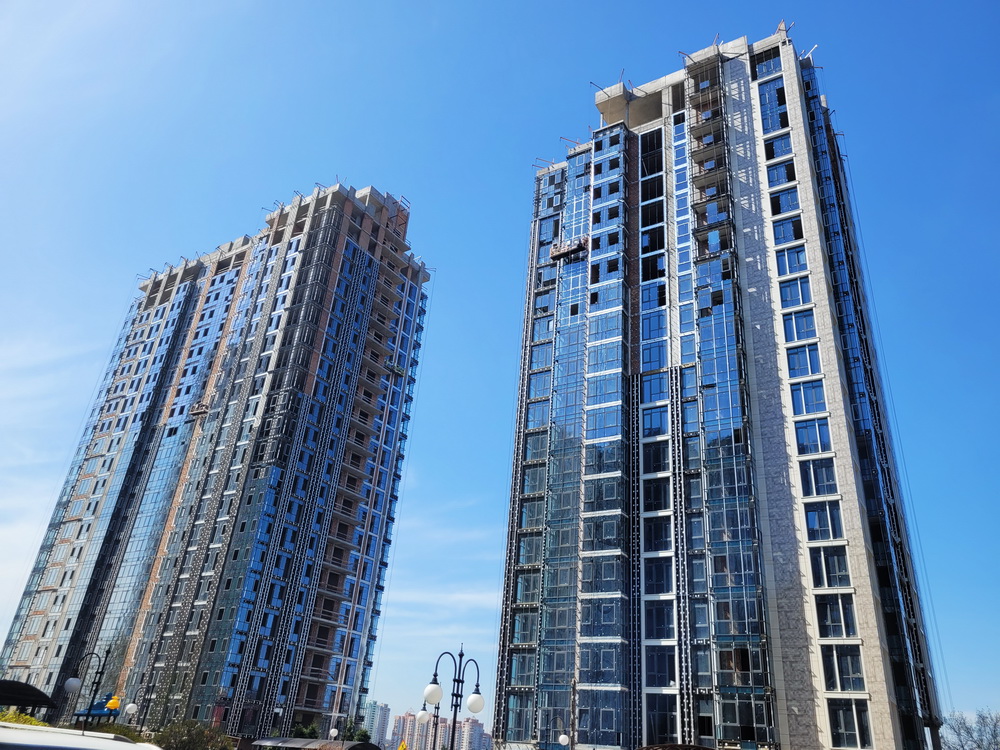

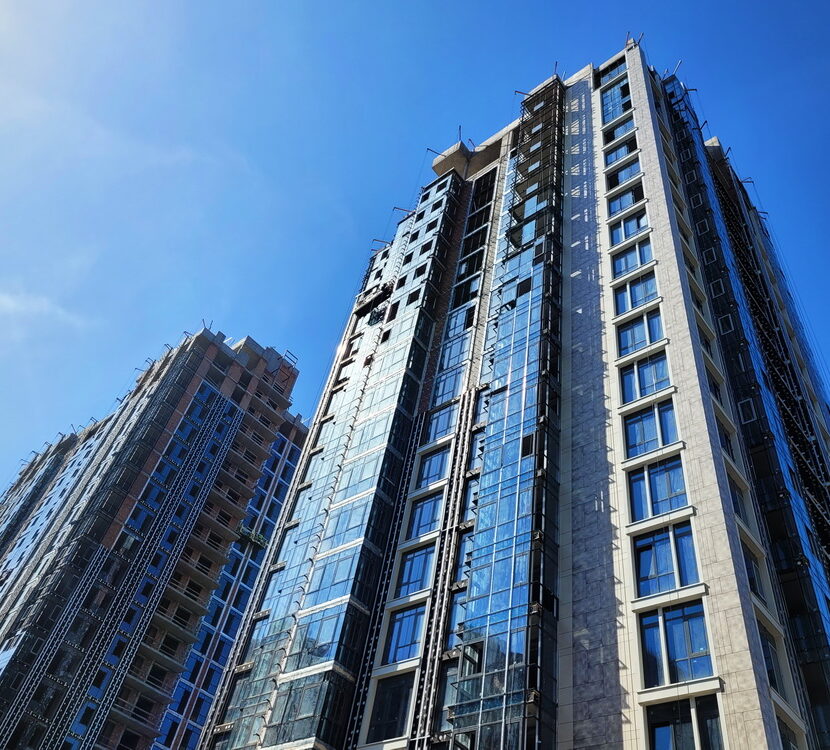

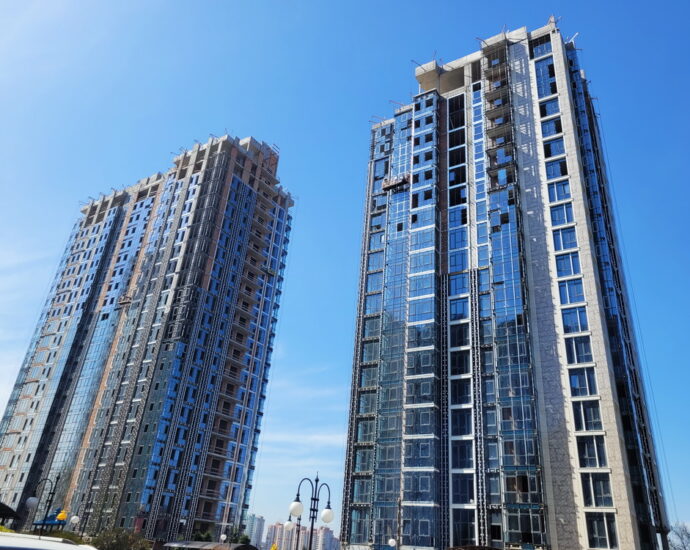

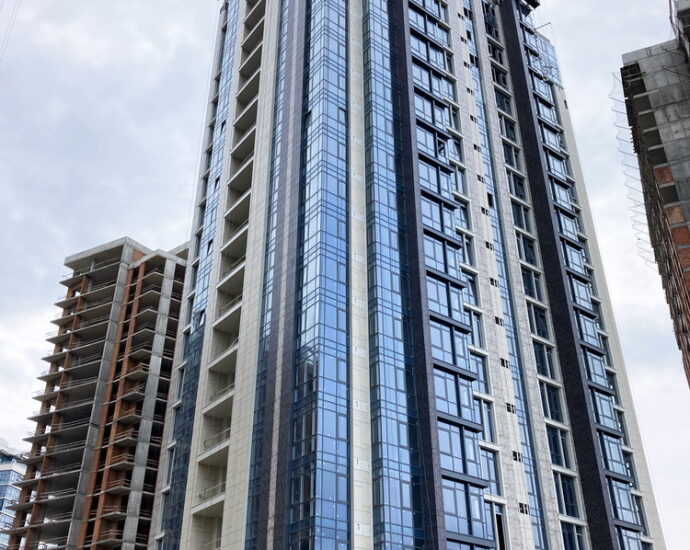

Building No. 2
- Continuing insulation of the building with mineral wool, securing protective geomembrane, and installing a ventilated facade.

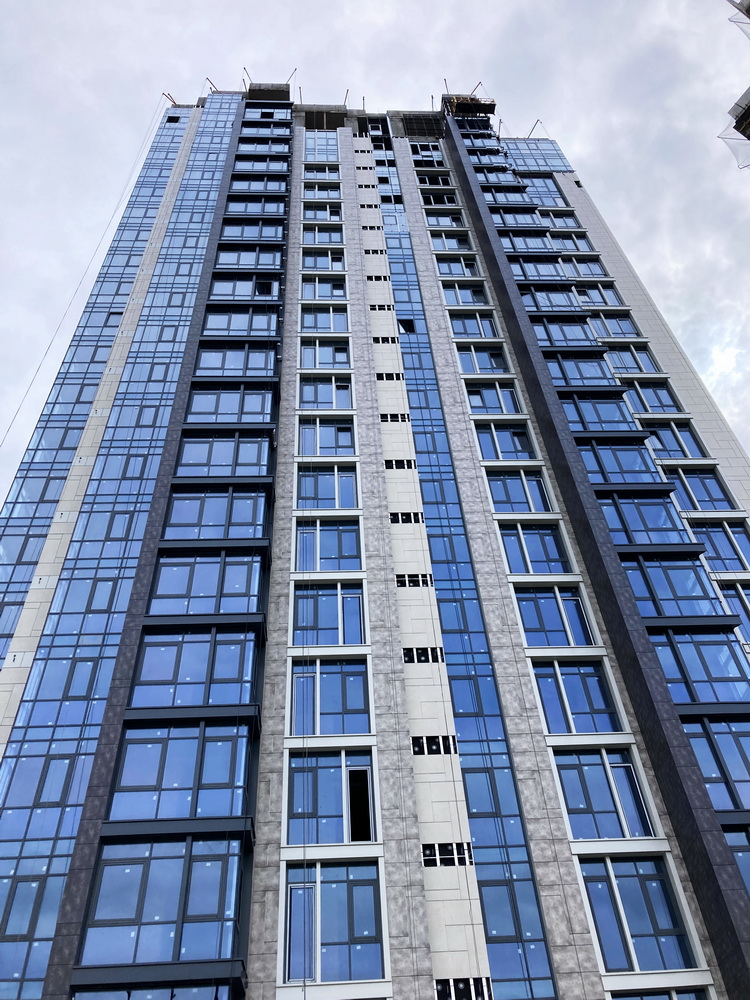

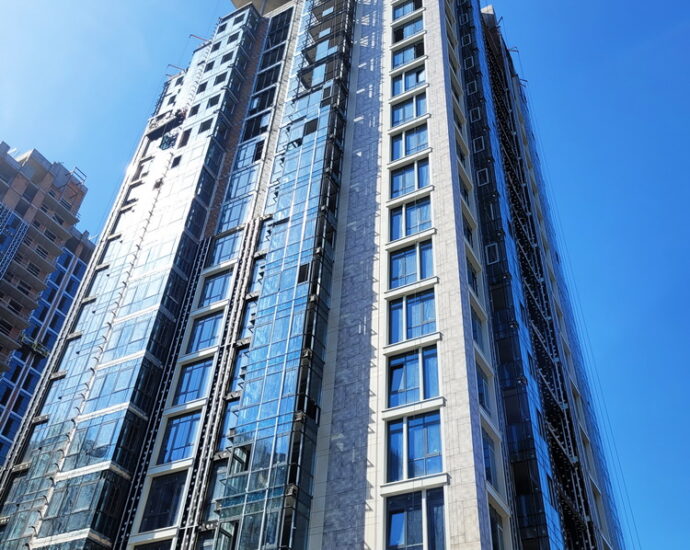

- Continuing the installation of aluminum window glazing and facade glassing.
- Arranging engineering networks for water supply and drainage, low-voltage alarm and automation systems, inflow-exhaust ventilation, and pumping systems for water supply.
- In the final stages of installing fire safety systems, heating, sewage, and water supply systems in the parking area between buildings 2 and 3.
- Continuing the installation of architectural facade lighting.

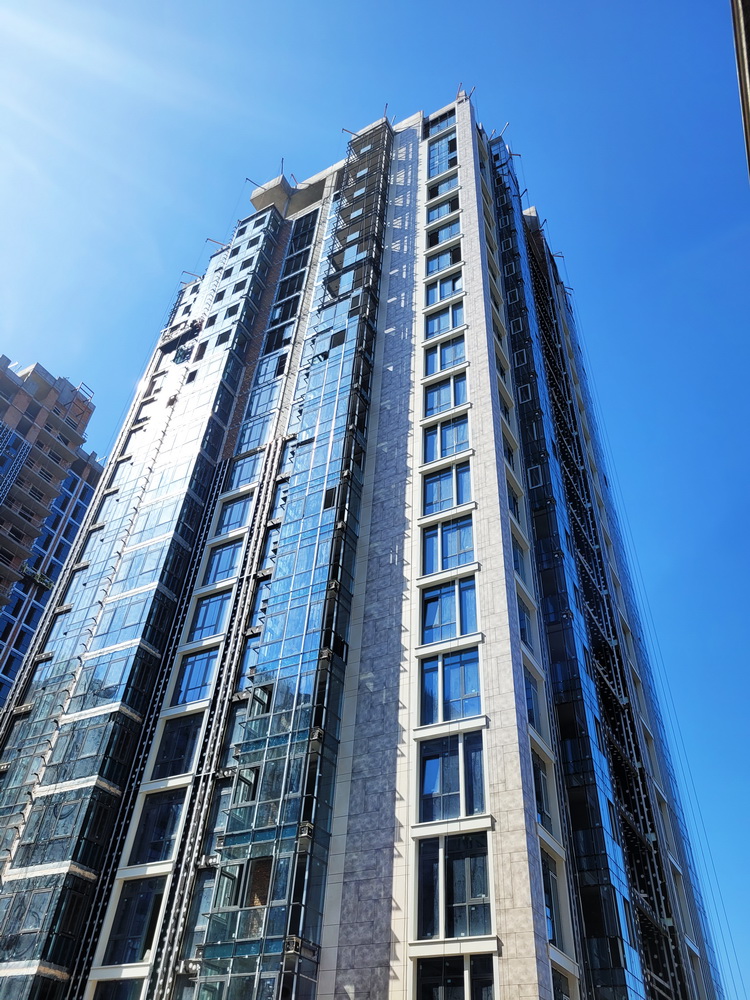

Building No. 3
- Completing insulation of the building with non-combustible mineral wool and installing a ventilated facade.
- Continuing the installation of aluminum window glazing and facade glassing.
- Continuing the arrangement of engineering networks for water supply and drainage, low-voltage alarm and automation systems, and inflow-exhaust ventilation.
- Installing architectural facade lighting.

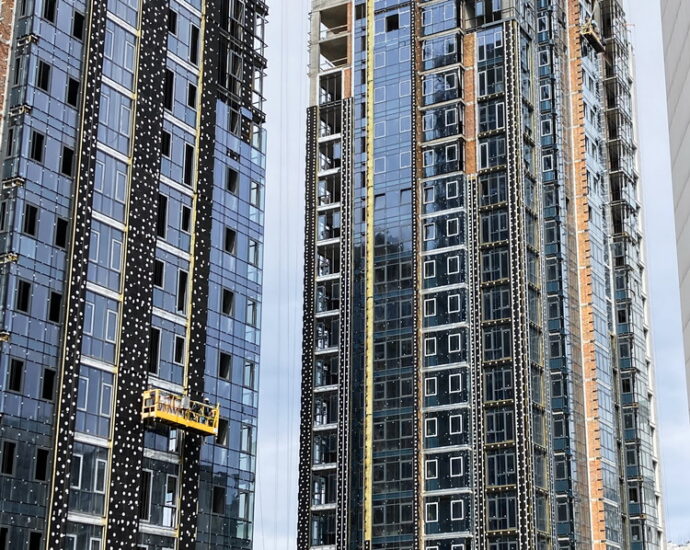

Building No. 4
- Completing the installation of the ventilated facade, aluminum window glazing, and glazing of window elements on the facade.
- Continuing the arrangement of engineering networks for water supply and drainage, low-voltage alarm and automation systems, inflow-exhaust ventilation.
- Completing the installation of architectural facade lighting.
Phase 8
Club-format Building No. 9

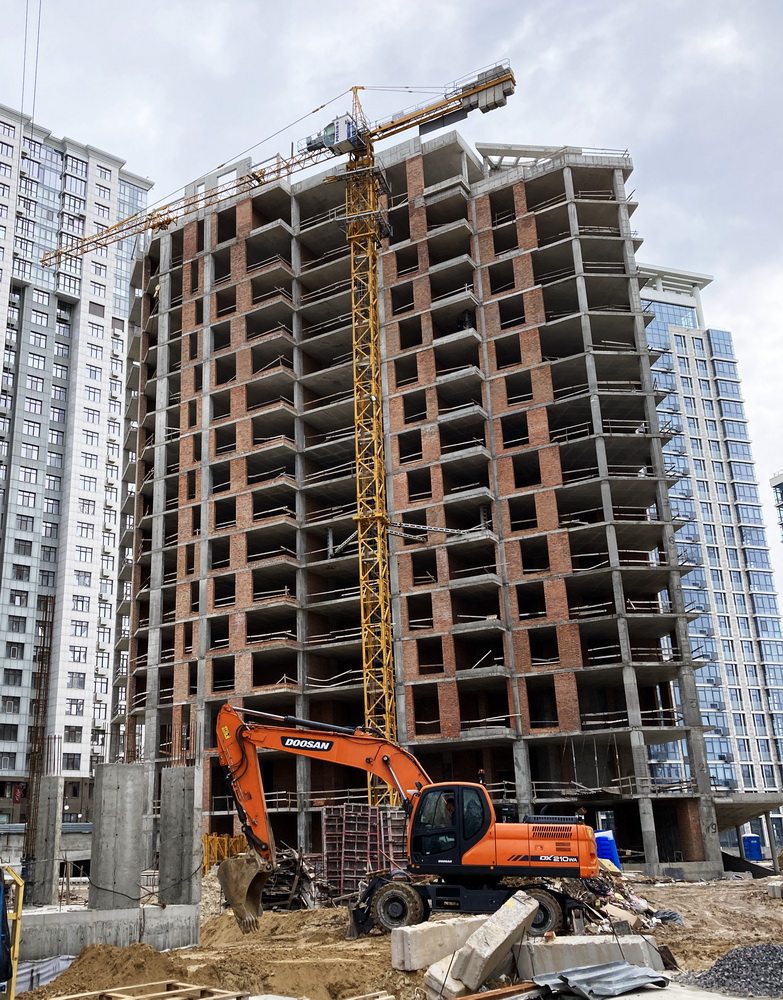

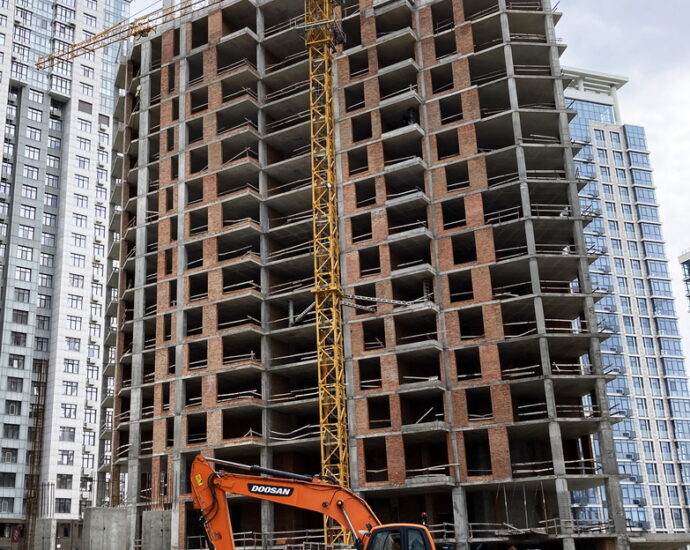

- Completion of masonry of external and internal walls.
- Dismantling of the tower crane Potain MC 175B.
- Continuing the installation of ventilation systems, water supply, and sewage risers.
- Ongoing arrangement of fire safety, alarm, dispatching, and automation systems.
- Completing the masonry of internal walls in the underground parking.
- Continuing the installation of elevator equipment, elevator cabins, and roof ventilation equipment.

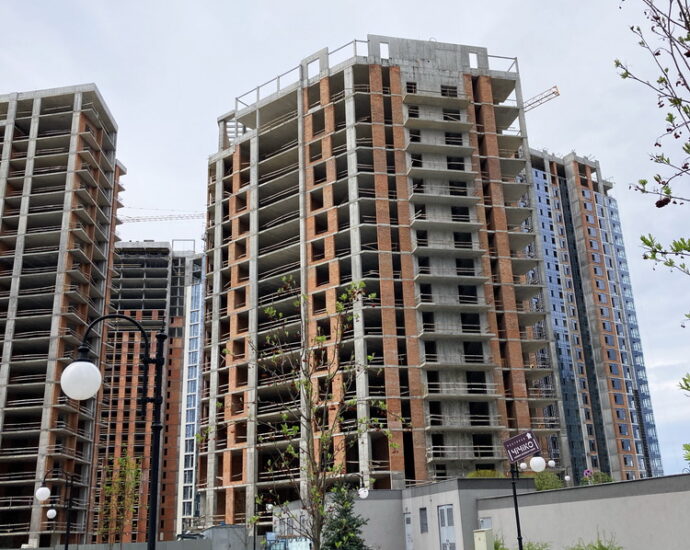

Building No. 5
- Completion of masonry of internal and external walls.
- Continuing the installation of ventilation systems, water supply, and sewage risers.
- Ongoing arrangement of fire safety, alarm, dispatching, and automation systems.
- Commencement of the installation of elevator and technological equipment.
Building No. 6

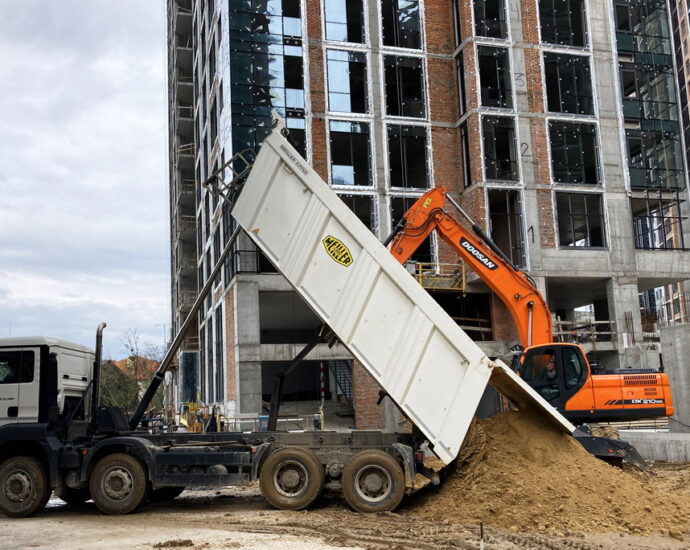

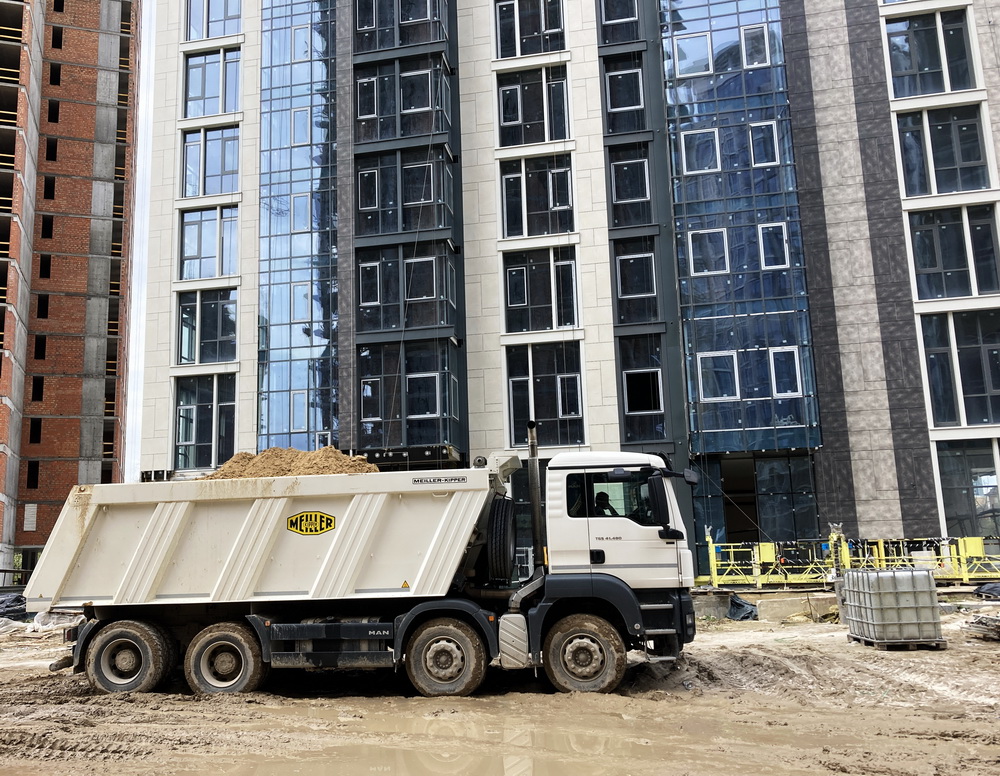

- Completion of construction up to the 10th floor and ongoing construction of the monolithic frame at the level of floors 11-12.
- Continuing the masonry of external and internal walls on floors 7-8.
- Ongoing work on the arrangement of the underground parking.
